Can pre-terminated fiber assemblies really speed deployments and cut failures vs on-site termination?

Can pre-terminated fiber assemblies really speed deployments and cut failures vs on-site termination?

Can pre-terminated fiber assemblies really speed deployments and cut failures vs on-site termination?

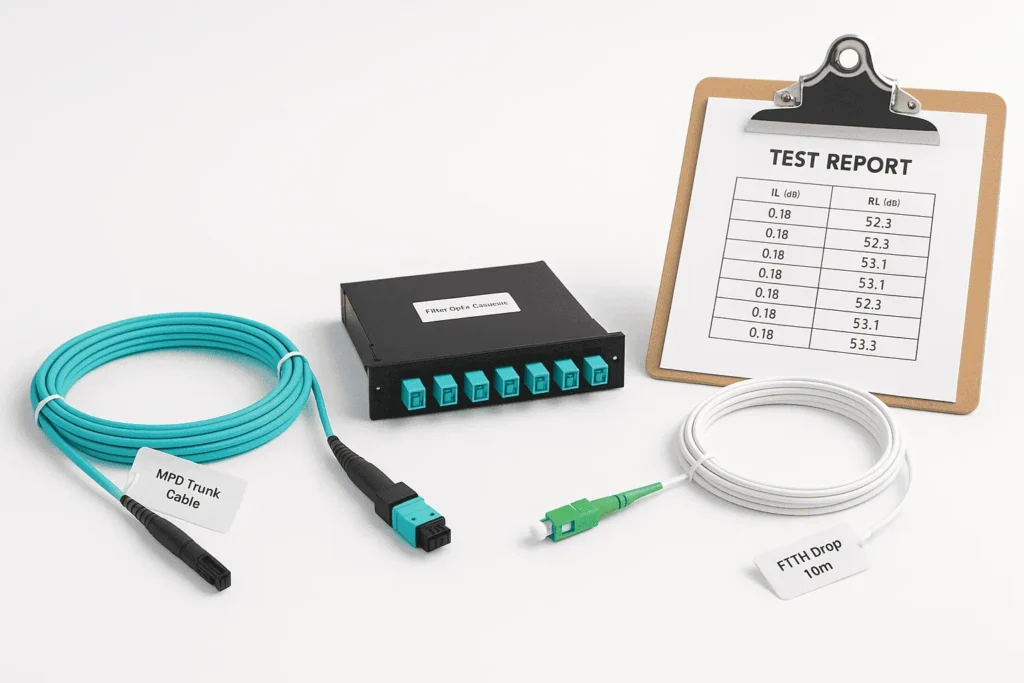

MPO trunk, MPO cassette and SC/APC FTTH drop on white background with IL/RL test report

Projects slip when field splicing drags. Dust, rain, and late-night shifts turn small mistakes into big rework. Pre-terminated fiber changes the game with factory-built, certified links you simply route and plug.

Yes. Pre-terminated fiber assemblies arrive cut-to-length with machine-polished connectors and 100% IL/RL reports. They remove splicing/polishing onsite, so crews focus on pulling, labeling, and validation. On like-for-like scopes, teams commonly save 30–50% install time and avoid most workmanship faults that trigger downtime and callbacks.

A panicked ISP PM once called me mid-FTTH rollout—bad weather and splice redo’s had blown the schedule. We switched his risers and drops to pre-terminated kits; crews just matched labels and plugged. In Spain, Fernando wins tenders with predictable performance. In the US, Bayan finished a weekend cutover in hours.

What exactly are pre-terminated fiber solutions—and how does plug-and-play work?

When you field-terminate, your team becomes a mini-factory in a dusty corridor. With pre-terminated builds, we move that fragile work to our cleanroom, then ship trunks, cassettes, harnesses, or drops with documents and labels that mirror your rack plan or MDU map.

Pre-terminated solutions are factory-made cables and modules—MPO/MTP trunks, MPO-LC/CS cassettes, fan-outs, and FTTH drops—delivered to spec, tested, labeled, and ready to plug. The result is faster installation, stable loss budgets, and cleaner handover packs with certified IL/RL.

Left: field tools and fiber shards; Right: MPO cassette with inspection microscope showing PASS

Common build types (with use cases)

  • MPO/MTP trunks & cassettes for high-density racks and leaf-spine backbones.
  • MPO→LC/CS harnesses to land multi-fiber ports on standard optics.
  • Pre-terminated FTTH drops (SC/APC) for curb-to-ONT and MDU risers.
  • Ruggedized jumpers (OptiTap®/FullAXS/NSN) for FTTA and outdoor cabinets.

Internal primers: Pre-terminated fiber optic solutions, How plug-and-play simplifies upgrades.
External overview: Ascent Optics: 5 benefits of pre-terminated fiber, trueCABLE: why pre-term is faster & cleaner.

Spec comparison (typical values)

ParameterMPO/MTP TrunkMPO→LC HarnessFTTH Drop (SC/APC)Typical Range / Notes
Fiber typeOS2 / OM3-OM5OS2 / OM3-OM5G.657.A1/A2Per design
Insertion loss (dB)≤0.35≤0.30≤0.30Connector grade drives range
Return loss (dB)≥30 (MM) / ≥50 (SM)≥30 / ≥55≥60 (APC)Typical
JacketLSZH/OFNP/PELSZH/OFNPPE/LSZHEnvironment-based
Docs100% IL/RL report100% IL/RL report100% IL/RL reportHandover pack

Why is traditional on-site termination slow, costly, and risky?

Field termination has flexibility, but variability kills schedules. Cleave, epoxy, polish, inspect, test—every step depends on skill, tools, and a clean table you rarely get outdoors or in construction dust. I once watched a Brazil crew spend a day re-doing splices from humidity alone.

On-site termination is a manual, multi-step process that needs certified techs, expensive splicers/cleavers, and clean conditions. It’s slower, costlier, and more error-prone—leading to inconsistent IL/RL, intermittent faults, and long troubleshooting loops after “go-live.”

Black cassette with teal MPO ports and coiled SC/APC drops; clipboard test sheet blurred

DIY pain points (at a glance)

DrawbackDescription
High labor demandCertified splicers; overtime during cutovers
Tool dependencyFusion splicer, cleaver, scope, consumables
Time per end10–20 minutes; multiplies with fiber counts
Environmental riskDust/humidity/temperature swings ruin ends
Inconsistent qualityHuman variability → rework and callbacks

Balanced comparison for stakeholders: Windy City Wire: field-terminated vs pre-terminated.
Deep-dive side-by-side: GCabling: complete comparison.

Field vs factory (what changes)

FactorField TerminationPre-terminated (Factory)
EnvironmentVariable, dustyCleanroom, sealed
Connector qualityTech-dependentMachine-polished, uniform
TestingSampled100% IL/RL with trace
Time per link5–20 min + setupSeconds (plug)
DocumentationAd-hocStandardized reports/labels

Install checklist (if you must splice)

StepToolPass/Fail CriteriaPitfalls
CleaveHigh-grade cleaver90° end faceDull blades
PolishFilm/puckNo scratches/pitsOver/under polish
Inspect200–400× scopeIEC pass“Clean but not inspected”
TestOLTS/OTDRBudget within specNo records kept

How do splice points threaten stability—and how do we avoid them?

Every splice is a potential weak link: alignment tolerance, seal quality, and mechanical stress all matter. In humid regions of LatAm or Africa, marginal closures slowly ingest moisture, and a clean trace today becomes a ticket tomorrow.

Splice points add loss, reflection, and mechanical risk. Misalignment, poor sealing, and vibration concentrate failures at the splice, degrading SNR and uptime. Fewer splices mean fewer tickets—pre-terminated links remove many of these weak points from the design.

Coiled 30 m FTTH drop with SC/APC plus three labeled SC/APC patch cords on gray backdrop

Failure mechanisms at splice points

MechanismWhat happensResult
Core misalignmentOff-axis fusionHigher IL / worse RL
Moisture ingressSeal fails; capillary actionCorrosion, micro-cracks
Thermal cyclingMaterial expansion mismatchLong-term drift, breaks
Vibration/tensionStress concentrationFracture at splice sleeve

Loss-budget best practices: FTTH testing & budgets.
Ready-to-use builds: Pre-terminated FTTH drop assembly guide.
External: NPI Connect: pre-terminated assemblies explained.

Quick loss-budget aide (example)

Link ElementQtyIL each (dB)Total (dB)
Connector pair (LC)20.200.40
MPO interface10.350.35
Splice00.100.00
Fiber (500 m @ 0.35 dB/km SM)0.18
Total0.93 dB

Procurement checklist to minimize risk

ItemSpec to confirmDoc requiredLead timeIncoterm
MPO trunksFiber count/polarityIL/RL report2–3 wksEXW/CIF
CassettesMPO→LC/CS mapLabel map1–2 wksEXW/CIF
FTTH dropsLength sets, SC/APCBatch test sheet1–2 wksEXW/CIF
ClosuresIP rating, gel vs gasketIP testStockEXW

Conclusion

Pre-terminated fiber replaces variable field work with controlled, documented builds. That shift shortens installs, stabilizes budgets, and removes many weak points that cause downtime. In my projects, it’s the fastest path to predictable cutovers and cleaner closeouts. If you need a plan or sample kit, reply with lengths, connector types, and site photos—I’ll map trunks, cassettes, and FTTH drops to your layout and include labeled packs and IL/RL reports for a smooth handover.
